9 October 2026
Structural steelwork supporting the recovery of a major glass manufacturing facility following a devastating fire.

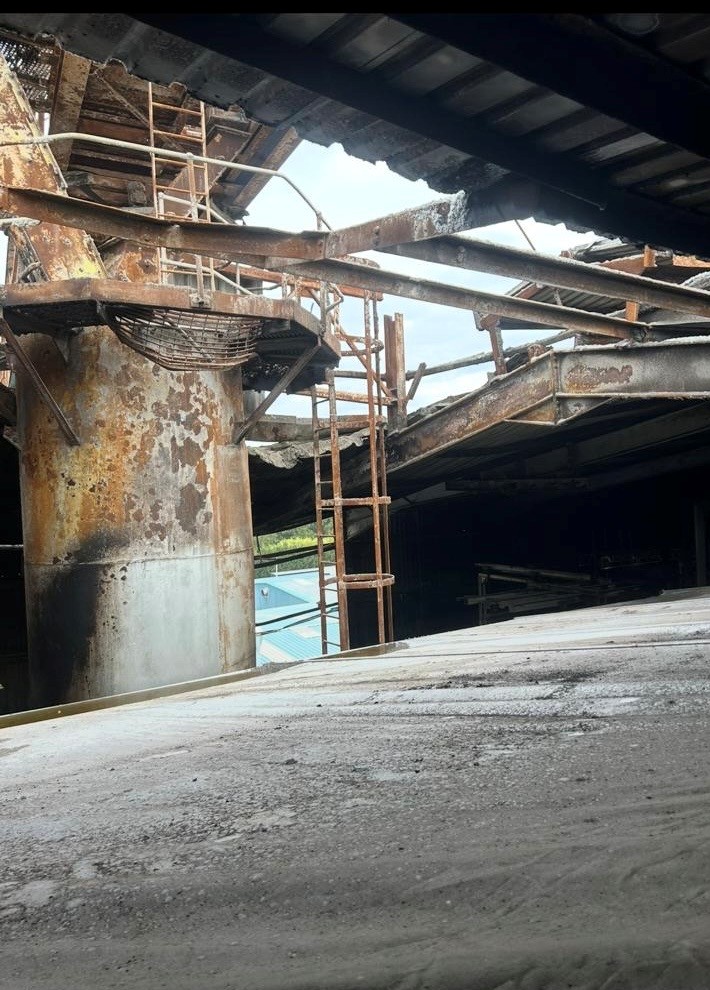

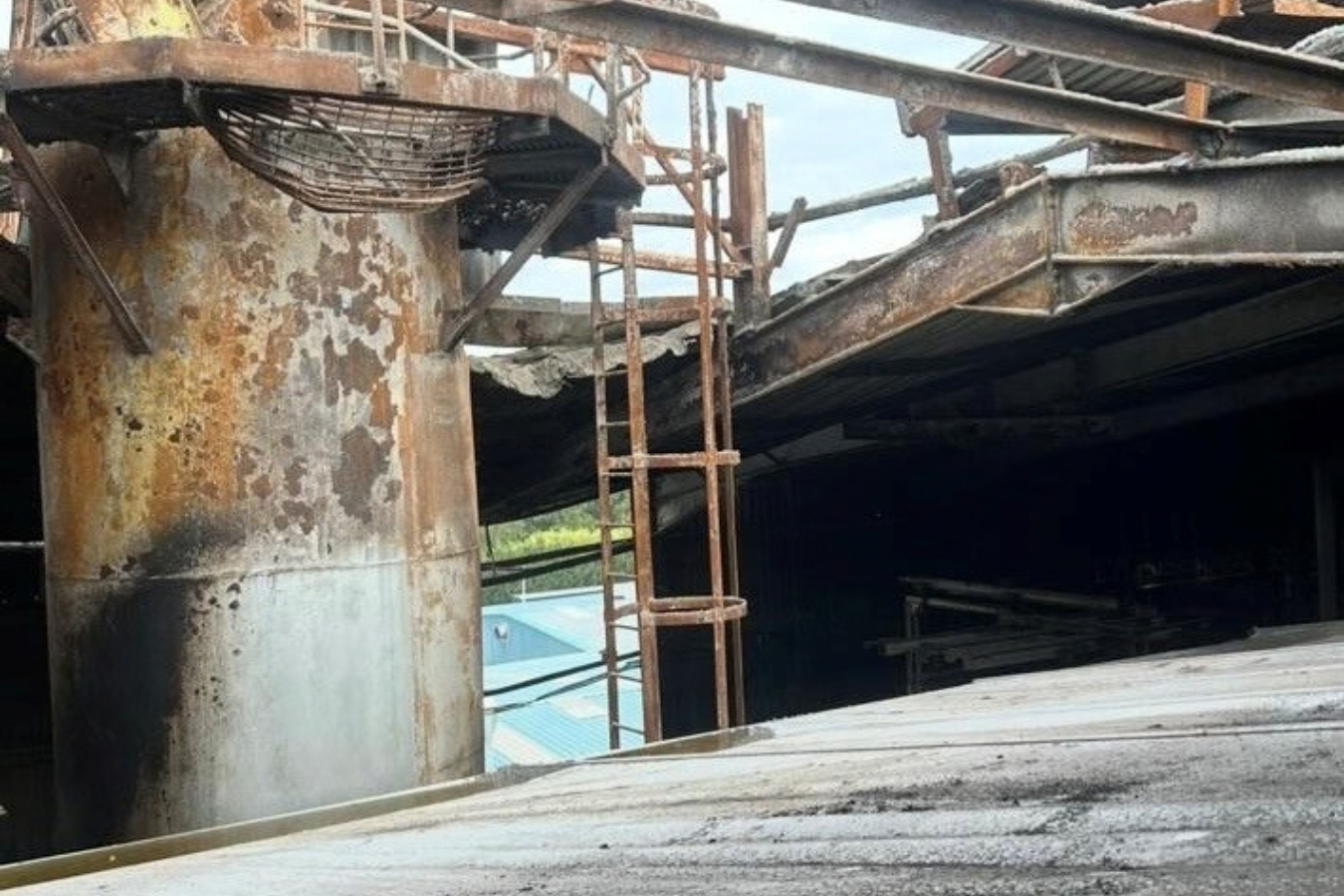

On 12 July 2025, a major fire tore through Stoelzle Flaconnage’s Knottingley facility. In its wake, the furnace and key production equipment were significantly damaged. Production ground to a halt.
The recovery programme had a clear objective: rebuild the affected areas and get the Knottingley facility back into operation before the end of the year.
Working as a specialist subcontractor to Havercroft, Fussey Engineering was drafted into the programme to deliver a significant package of structural modifications and new steelwork.

Fussey Engineering was working inside an established industrial structure, in the middle of a much larger recovery programme.

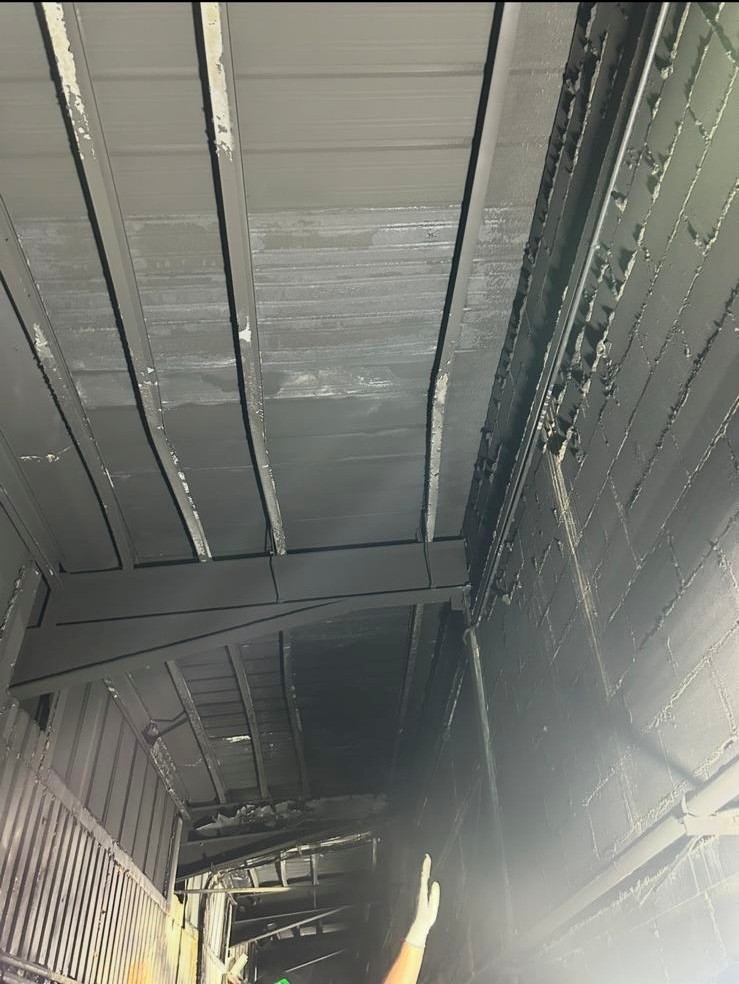

Existing columns, rafters and purlins had to be removed and replaced. New steelwork had to integrate accurately with what remained. Installation was taking place at roof level, around existing infrastructure, while specialist contractors worked across the site to bring the facility back online.
There was little room for one part of the programme to disrupt another. And the clock was already ticking.
Accuracy was key. But it wasn’t simply about fabrication. Replacement and new steelwork had to integrate with the existing structure and be planned around how it would ultimately reach its position on site.
Roof-level working, crane-assisted lifts, existing infrastructure and the work of other specialist contractors all had to be considered as part of the same structural package.
Every decision had to think beyond the drawing in order to keep the wider recovery programme moving.

With the approach established, Fussey Engineering’s package moved from planning into delivery: removing and replacing damaged structural steelwork, integrating new steel into the existing structure and constructing a new penthouse frame.

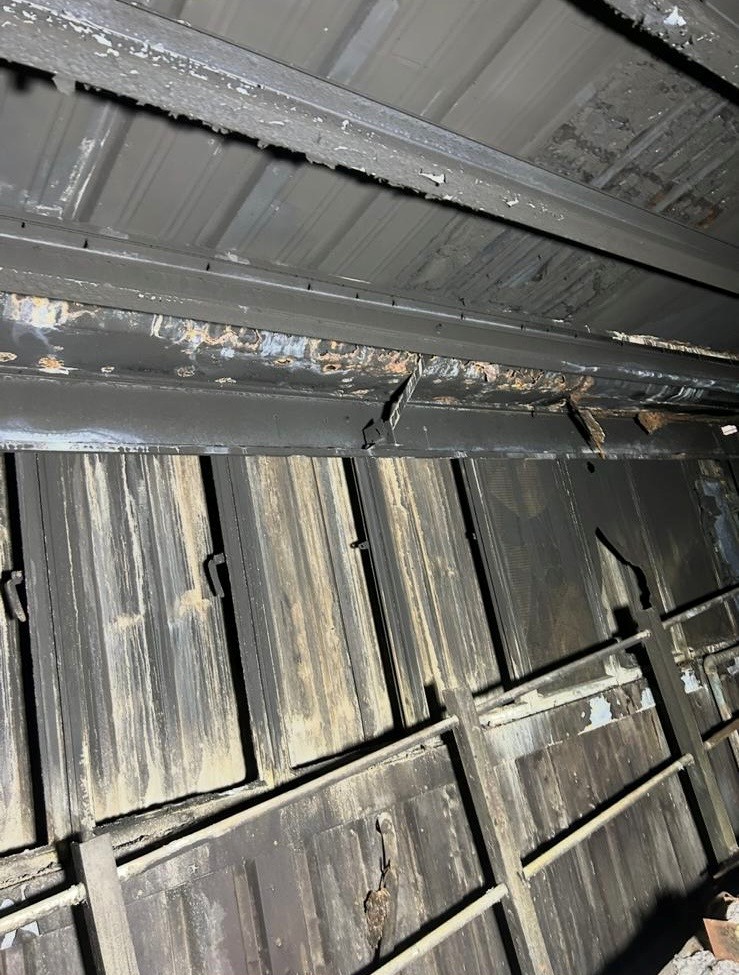

Columns, rafters and purlins were removed and replaced within the existing industrial structure.

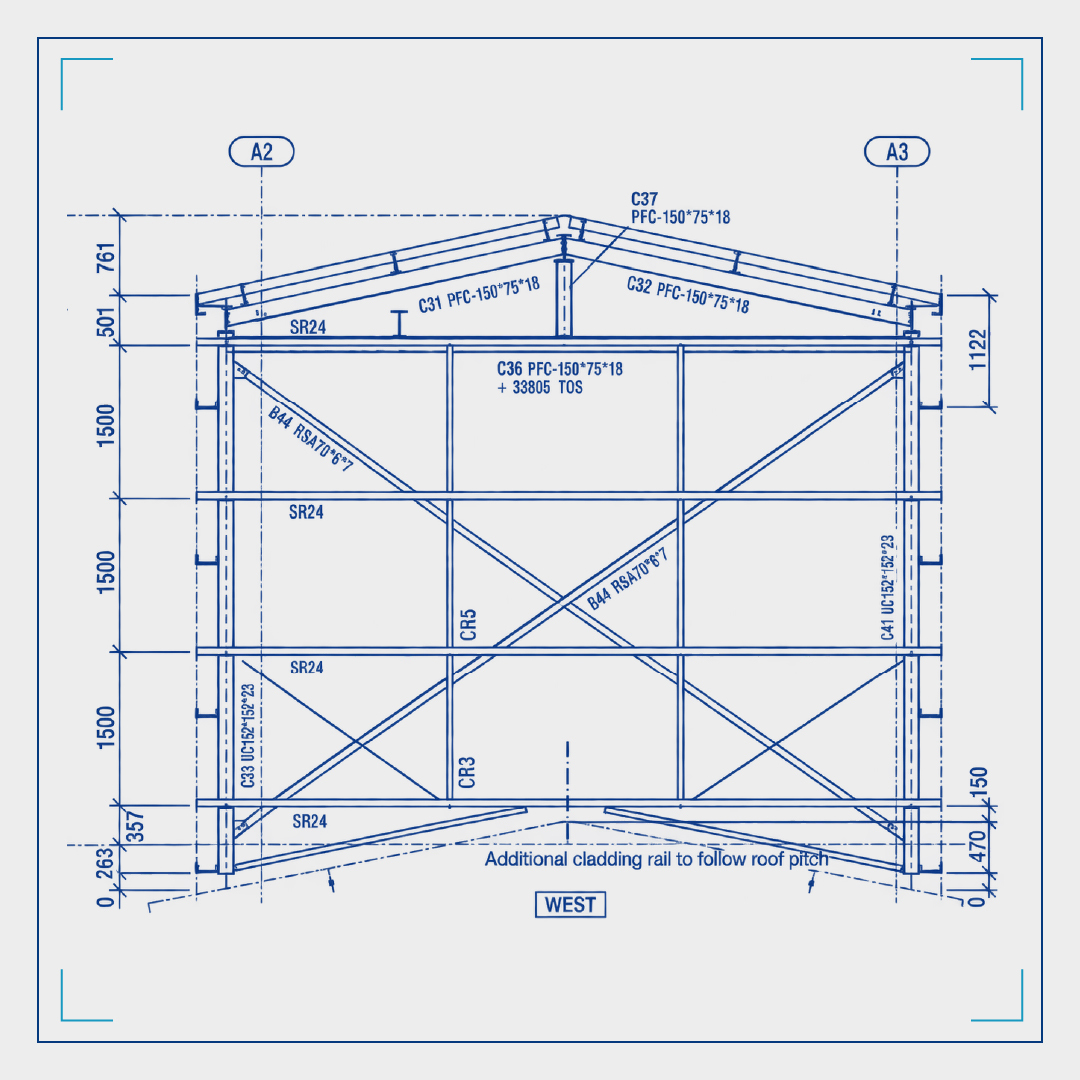

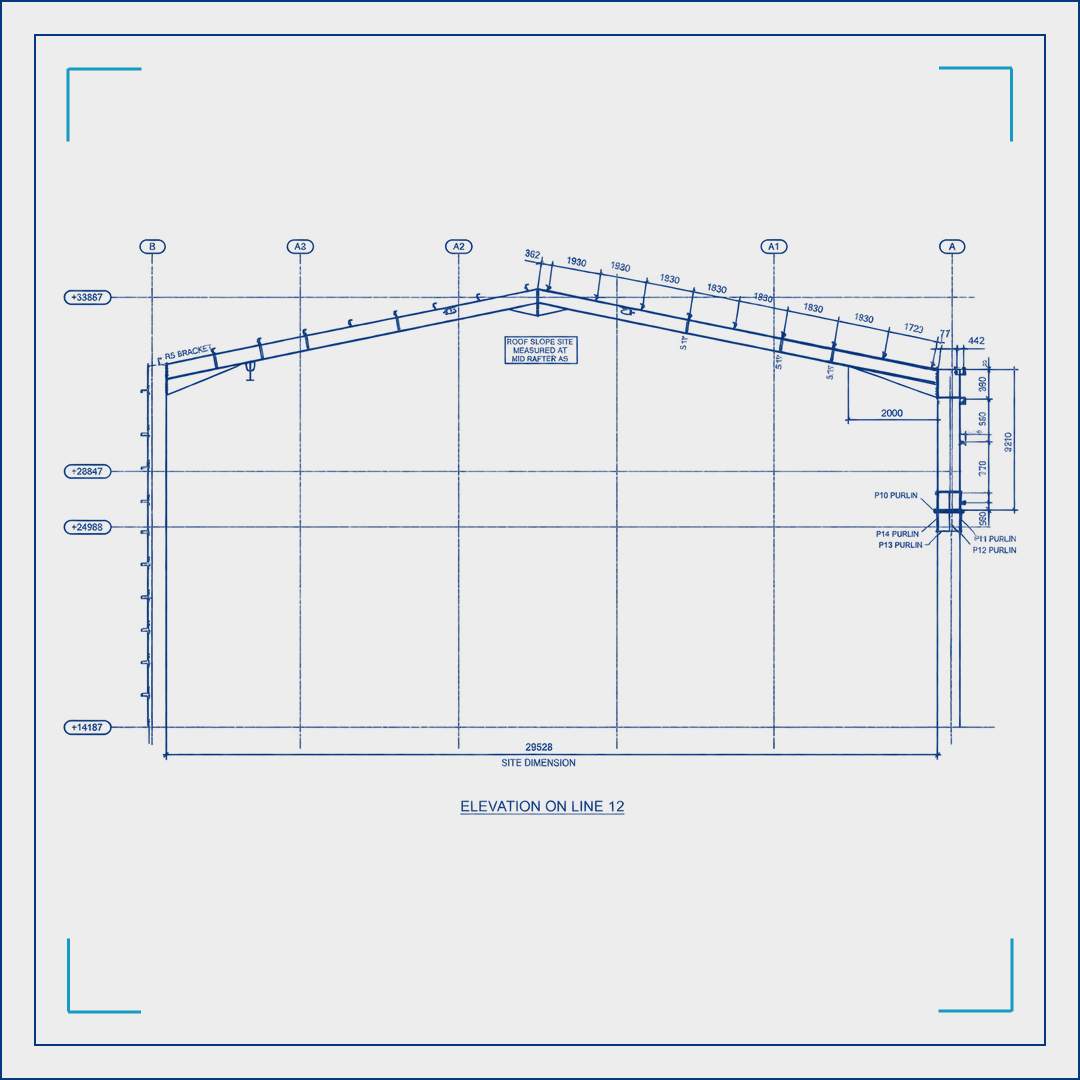

A new steel frame was fabricated and installed, incorporating columns, welded gusset plates, rafters and purlins.
New and replacement steelwork was accurately connected into the structure that remained, bringing the thinking from detailing through to fabrication and installation.

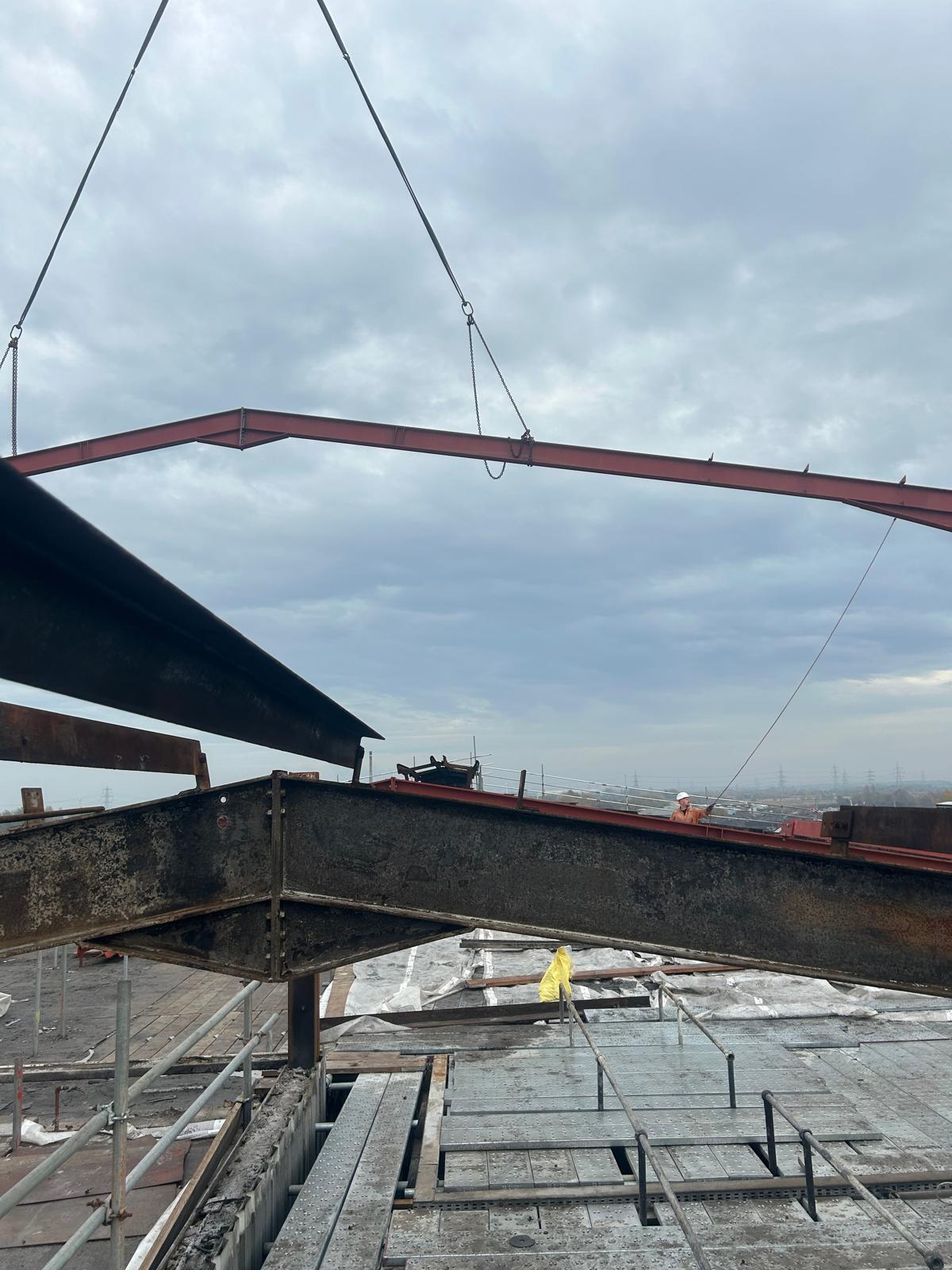

Structural members were crane-lifted into position and installed at roof level, working around the existing structure and infrastructure below.

Four months after Fussey Engineering entered the recovery programme, its structural steelwork package was complete.
It formed part of a much wider recovery effort, with multiple teams and specialist contractors working towards one shared objective: get Knottingley back into production.

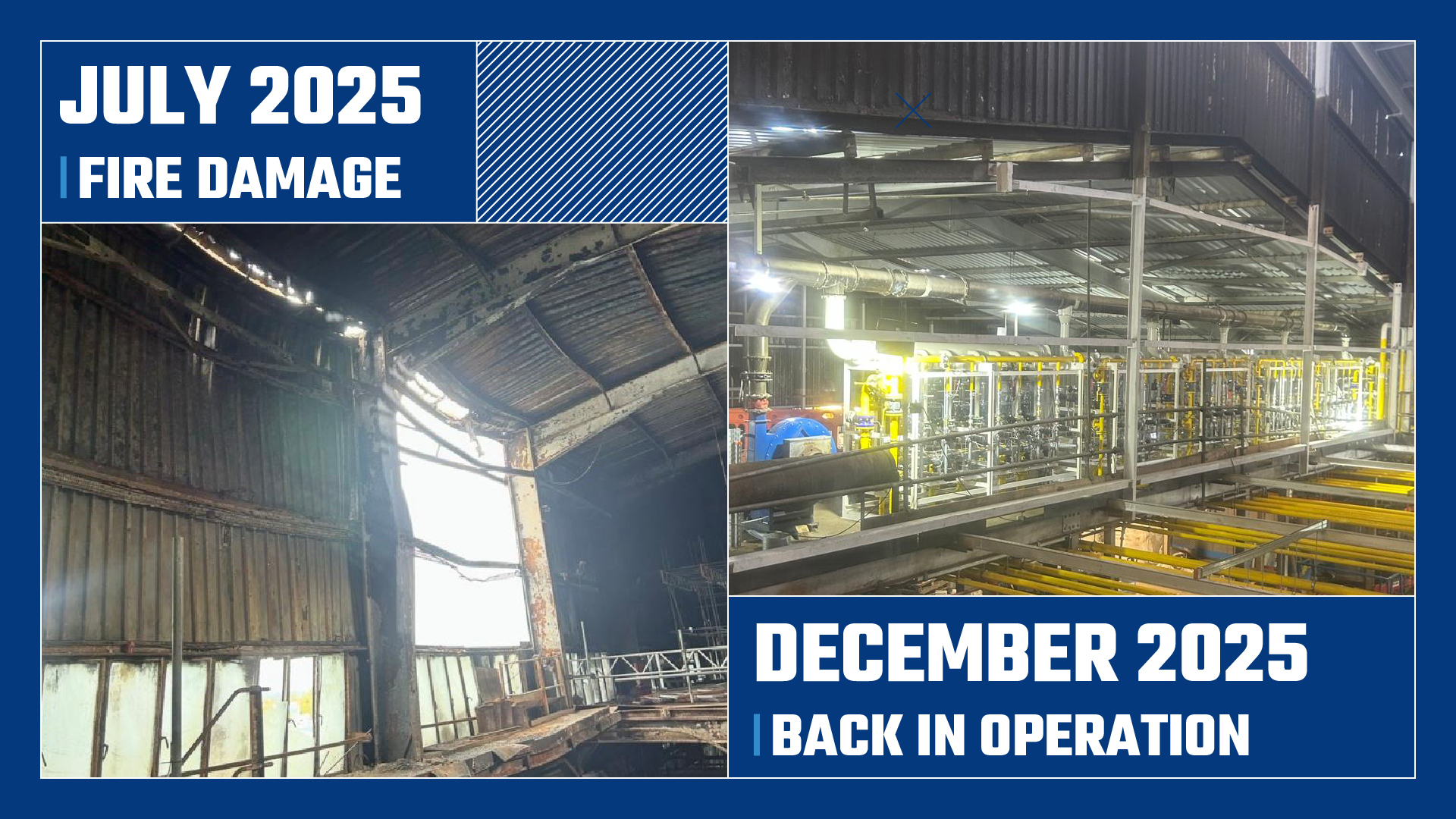

Following furnace heat-up, commissioning and testing, that objective was achieved. In December 2025, Stoelzle restarted operations at Knottingley.
Fussey structural steelwork programme
Structural modifications and new steelwork
Crane-assisted structural erection
Knottingley back in operation
